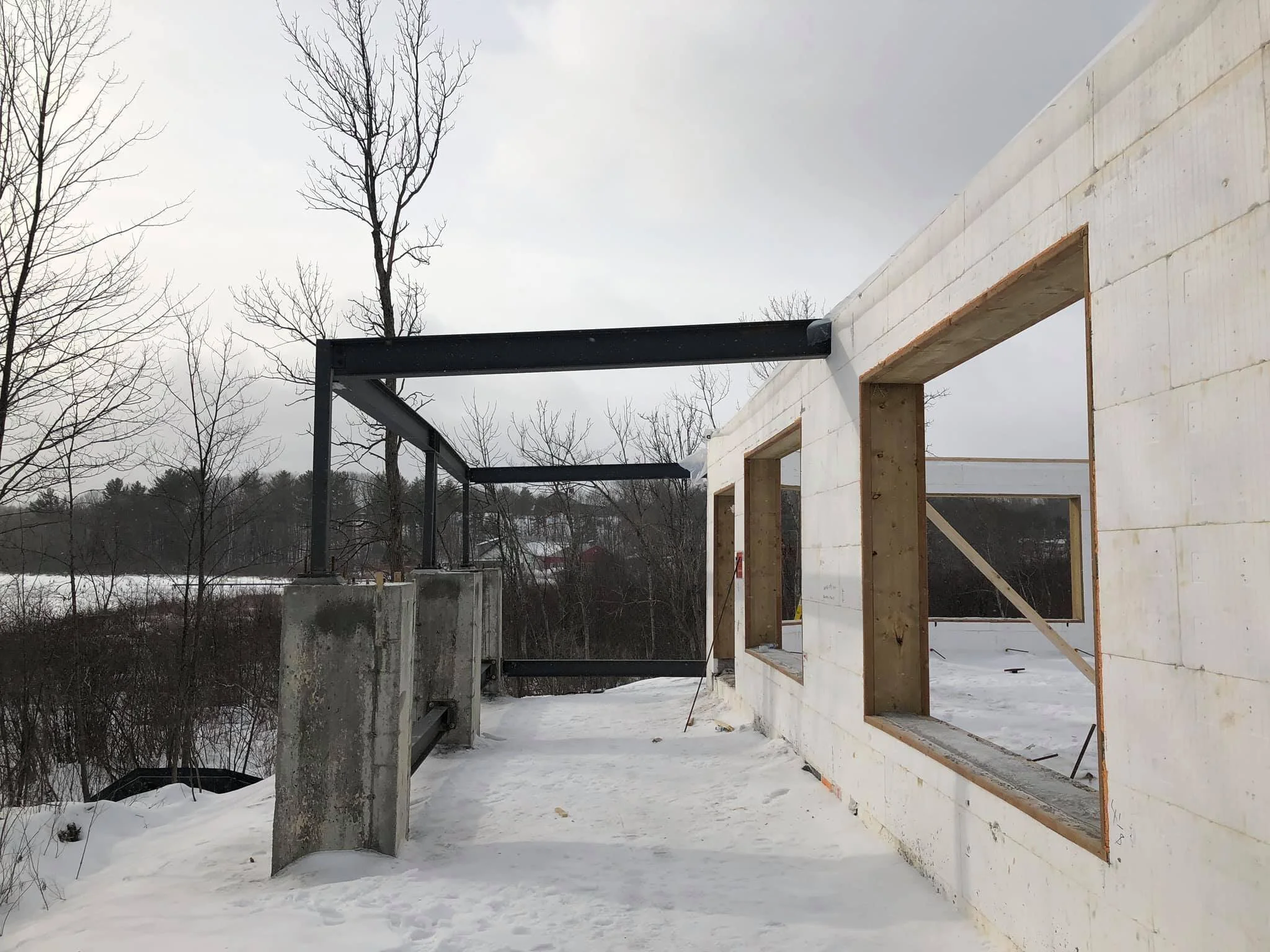

January 9th 2019

All the steel has now been completed. Next will be the wood beams and trusses.




January 24th 2019

Andy’s House is moving along. Today Cutting Brothers Inc. started with the trusses which will take about 3 weeks if Mother Nature cooperates!




February 3rd 2019




February 5th 2019

Moving along with trusses.




April 1st 2019

The ice and water shield is going on now and they will start installing the windows when this has been completed




April 9th 2019

Andrew and the guys from Greystone installing the last of the four big windows off of the great room.

Our fireplace is really taking shape! Look way up. Thanks to The Fireplace Stop and to Grant Watkinson of Shorline Construction Ltd.




June 5th 2019

Various things on the go at Andy’s House this week. Steel roof, stone work and then prep for the floor inside. In 7-10 days the slab will be poured for the floor!




June 7th 2019

Beautiful Friday afternoon with the boys from Craig Beard Masonry. Works looking great!



Your Local HVAC Team Inc has completed the work for the radiant floor heat! Slab to be poured on Wednesday which will be a significant Milestone.




June 13th 2019

Today is the big day! 158 meters of cement going into the floor of Andy’s house.



The cement pad is now complete!




June 22nd 2019




June 28th 2019

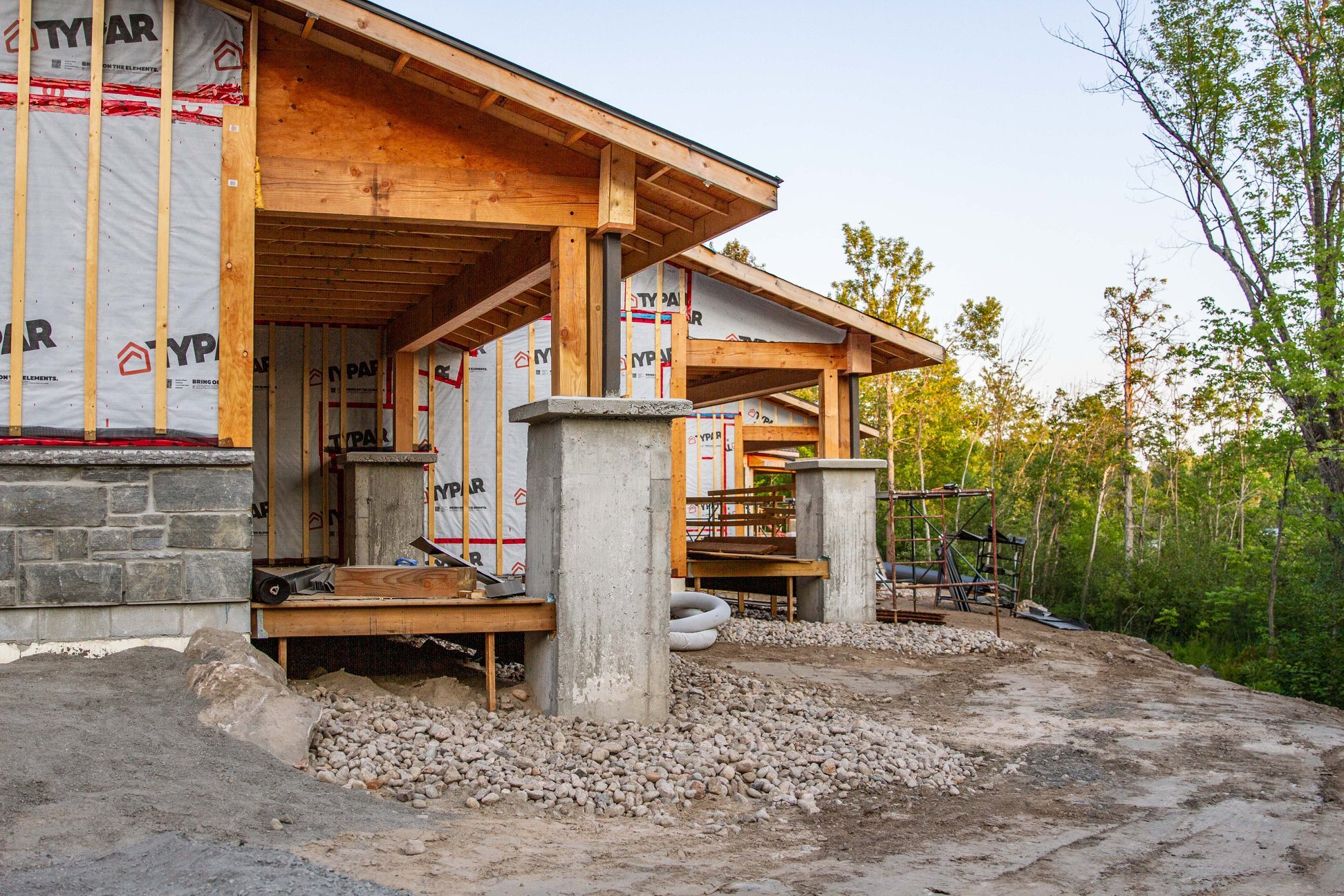

Rooms being laid out and walls to be completed by the end of next week. Insulation completed.
Thanks to MKG Contracting and Muskoka Custom Insulation.




July 9th 2019

Rooms are starting to take shape with the steel studs going in and HVAC started.




July 15th 2019

Justin from Rieger Contacting putting in soil retention system for Andy’s House!




July 24th 2019

Spoke with Shane Spencer of Signature Stone Masonry today. He’s doing the masonry work for Shorline Construction Ltd. This is going to be one awesome fireplace when completed! Check it out.




August 1st 2019




August 31st 2019
